• 2016 Bond Quarterly Construction Update

    Plano ISD has realized tremendous growth during the past several decades. Keeping up with this growth has been challenging and rewarding. Our Planning and Construction Department reports the progress of construction and renovation projects on a quarterly basis.

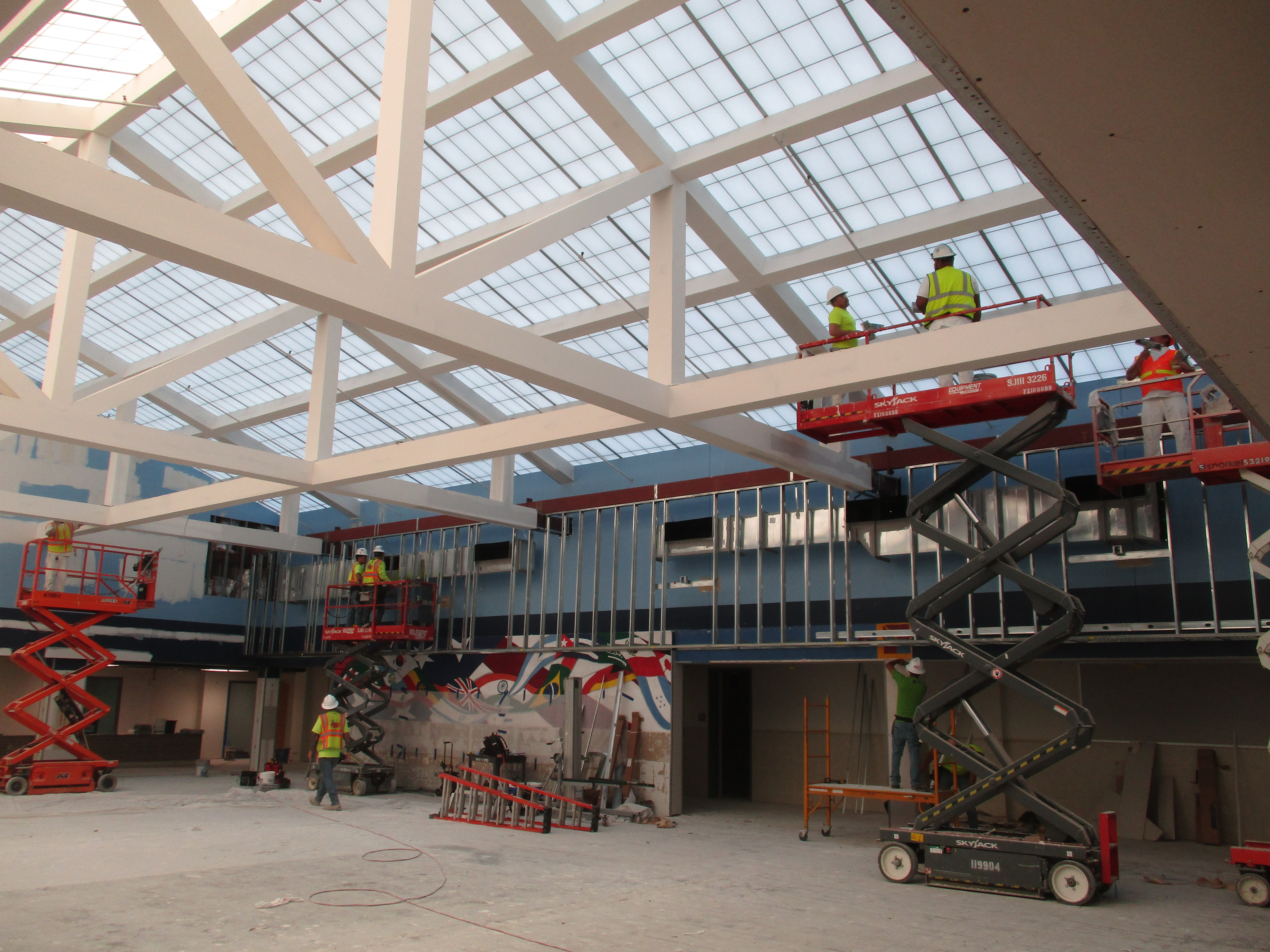

     Bowman MS renovation

Administration

    • Chief Financial Officer, Randy McDowell

Facility Planning and Construction

    • Executive Director of Facility Services, Juan Ramos
    • Assistant Director of Facility Services, Tony Pearson
    • Construction Manager, Johnny Pechacek
    • Construction Administrator, Robert Dean
    • Construction Administrator, Warren Kinsey
    • Construction Administrator, Quincy Lara
  • New Construction

    Scroll down to view bond new construction projects:

    • Early Childhood School 4
    • Fine Arts Center

    Early Childhood School 4

    Mapleshade Lane, Dallas, TX 75252

    • Architect: VLK Architects
    • Contractor: Cadence McShane
    • Plano ISD Construction Administrator: Warren Kinsey

    Scope

    Enlarge the capacity of the district's Early Childhood Program by constructing a fourth campus. The new school will be modeled after the Sara Isaacs Early Childhood School, but will also contain a kitchen and dining area. The building will be approximately 62,500 SF. Site conditions such as circulation, fire lanes, parking, landscape and irrigation will also be included in the work and overall planning.

    Timeline

    • Design Initiated: 6/2017
    • Design Completed: 4/2018
    • Construction Started: TBD
    • Scheduled Construction Completion: TBD

    Status

    The Board requested further study on the district’s immediate need for a fourth early childhood school. To be brought forward at a subsequent time.  Contracts with both the contractor and architect have been closed.

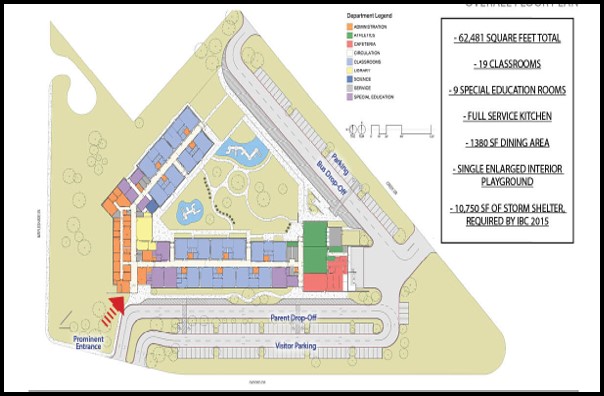

    Early Childhood School 4 floor plan

    Overall Floor Plan, June 2018

    Early Childhood School Main Entry Rendering

    Main Entry Rendering, June 2018

    Fine Arts Center

    1800 Alma Drive, Plano, TX 75075

    • Architect: P+W/BORA
    • Contractor: McCarthy
    • Plano ISD Construction Administrator: Johnny Pechacek, Warren Kinsey

    Scope

    Provide a venue to showcase music, dance, theater and the visual arts. The facility will be approximately 82,200 SF spread across two levels.  The main theater will have 1,500 seats and one balcony level. The building will also have a flexible 200 seat Studio Theater, large Rehearsal Room and Gallery component for exhibitions. Designed to host art contests, including University Interscholastic League (UIL) competitions with schools from outside of the district. The facility also has the potential to host outside performances and events, bringing art and culture from a variety of sources into the community of Plano.

    Timeline

    • Design Initiated: 2/2017
    • Design Completed: 6/2018
    • Construction Started: 2/2019
    • Scheduled Construction Completion: 12/2020

    Status

    Lobby and Gallery grade beams are currently being formed and poured.  Slab to follow. Walls are beginning to go vertical at the Stage and Main Theater. The Studio Theater slab has been poured and walls are preparing to start going up. The Back of House is expected to start steel in November.

    Construction Contract Amount

    $53,334,356

    Aerial site photo

    Aerial view of site, October 2019

    Walls going vertical construction photo

    Walls going vertical, October 2019

    Building under construction

    October 2019

  • New Acquisitions

    Scroll down to view bond new acquisition projects:

    • Special Education Adult Transition Center
    • Employee Childcare 3

    Special Education Adult Transition Center

    1631 Dorchester Dr., Plano, TX 75075

    • Architect: PBK Architects
    • Contractor: District Approved Vendors
    • Plano ISD Construction Administrator: Warren Kinsey

    Scope

    Interior finish-out and building infrastructure upgrades to provide one center for all Special Education Transition Services for the District. Transition services are a coordinated set of activities designed as a results oriented process that promotes movement from school to post-school activities, including: post-secondary education, vocational training, integrated employment (including supported employment), continuing and adult education, adult services, independent living, or community participation.

    Timeline

    • Building Purchased: 4/2017
    • Previous Owner Moved Out: 5/2018
    • Construction Started: 6/2018
    • Construction Completed: 8/2018

    Status

    Substantially Complete. The main entry canopy is expected to start and complete mid October. A ceremony for the official sign unveiling is slated for October 10. The building will be named after Charmaine Solomon who is one of the founders of My Possibilities.

    Construction Contract Amount

    $700,000

    Life Skills Room, January 2019

    Life Skills room, January 2019

    Dining_Sept2018

    Dining, September 2018

    Employee Child Care 3

    600 Old Custer Rd., Allen, TX 75013

    • Contractor: District Approved Vendors
    • Plano ISD Central Cluster Manager: Jason Wink

    Scope

    Renovate the recently purchased Montessori school and turn it into an  Employee Child Care Center.  Child Care Centers are licensed through the Texas Department of Family and Protective Services.  The District’s Employee Child Care was created to provide a service for our teachers. The exceptional centers have proven to be a valuable tool in the retention and recruitment of the very best teachers in North Texas. This will be the District’s third employee child care.

    Timeline

    • Building Purchased: 8/2017
    • Building Licensed: 6/2018
    • Building Opened: 8/2018

    Status

    Complete.

    Actual Construction Cost

    $4,546,199

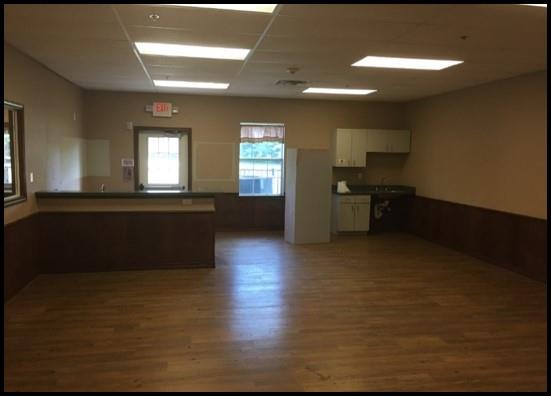

    Interior Rooms Under Construction_June2018

    Interior Rooms Under Construction, June 2018

    Classroom View_March2019

    Classroom View, March 2019

  • Added Capacity

    Scroll down to view bond added capacity project for Gulledge Elementary.

    Gulledge Elementary School

    6801 Preston Meadow Drive, Plano, TX 75024

    • Architect: WRA Architects
    • Contractor: Lee Lewis Construction
    • Plano ISD Construction Administrator: Quincy Lara

    Scope

    Provide a six classroom addition, along with associated site-work and paving.

    Timeline

    • Design Initiated: 6/2019
    • Scheduled Design Completion: 11/2019
    • Scheduled Construction Start: 2/2020
    • Scheduled Construction Completion: 8/2020

    Status

    Lee Lewis Construction was approved as the general contractor at our September 3rd Board. Plans are currently in the design development phase and quickly moving towards construction documents as the goal is to go out for bid the first week of November.

    Estimated Construction Budget

    $3,400,000

    Gulledge classroom addition location aerial photo

    Classroom Addition Location, July 2019

    Architect's Early Rendering

    Architect's Early Rendering, October 2019

  • Major Renovations

    Scroll down to view bond major renovation projects:

    • Robinson Middle School
    • Shepton High School

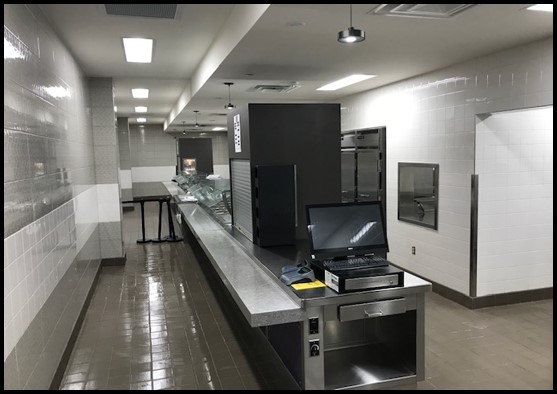

    Robinson Middle School

    6701 Preston Meadow Dr, Plano, TX 75024

    • Architect: Corgan
    • Contractor: Cadence McShane
    • Plano ISD Construction Administrator: Robert Dean

    Scope

    Provide a major renovation of the existing campus. The design includes approximately 17,900 square feet of addition, and renovation of most of the school’s existing floor plan. The renovation looks to enlarge undersized classrooms, improve interior building circulation, remodel the kitchen, provide new finishes (flooring, paint and tile) throughout, improve upon the athletic locker room spaces, address major building systems (electrical, mechanical, plumbing), and install a new roof. It will also be the second school in the district to go geothermal.

    Timeline

    • Design Initiated: 3/2017
    • Design Completed: 2/2018
    • Construction Started: 3/2018
    • Scheduled Construction Completion: 8/2019

    Status

    Substantially complete. Continuing to correct punch list items.

    Construction Contract Amount

    $27,971,729

    Remodeled kitchen

    Remodeled Kitchen, October 2019

    Renovated science lab

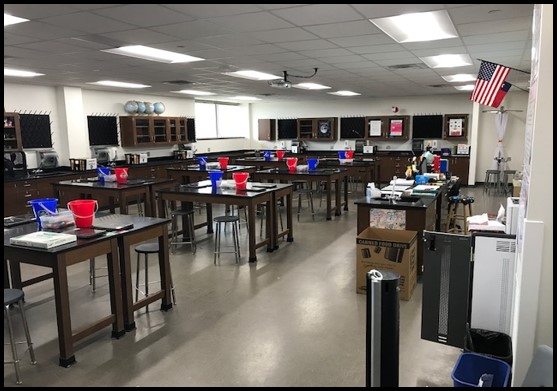

    Renovated Science Lab, October 2019

    Shepton High School

    5505 Plano Parkway, Plano, TX 75093

    • Architect: VLK Architects
    • Contractor: Pogue Construction
    • Plano ISD Construction Administrator: Robert Dean

    Scope

    Provide a major renovation of the existing campus. The design consists of approximately 28,000 square feet of addition, and renovation of most of the school’s existing floor plan. The renovation looks to enlarge undersized classrooms, improve interior building circulation, remodel and expand the kitchen, enclose the cafetorium and acoustically treat it for performances, provide new finishes (flooring, paint and tile) throughout, improve upon the athletic locker room spaces, address major building systems (electrical, mechanical, plumbing), install a new roof, and improve the site drive lanes.

    Timeline

    • Design Initiated: 5/2016
    • Design Completed: 3/2017
    • Construction Started: 4/2017
    • Construction Completed: 8/2018

    Status

    Complete.

    Construction Contract Amount

    $36,471,849

    Actual Construction Cost

    $36,471,849

    Shepton entrance stairs

    Shepton High School Entry, July 2019, photo credit: Chad Davis Photography

    Shepton collaboration space

    Collaboration Space, photo credit: Chad Davis Photography

    Shepton commons area

    Student Commons, July 2019

  • Upgrades/Refurbishments - Elementary Schools

    Scroll down to see the following elementary school bond upgrade/refurbishment projects:

    • Barksdale
    • Gulledge
    • Haggar
    • Haun
    • Miller
    • Skaggs

    Barksdale Elementary School

    2424 Midway Road, Plano, TX 75093

    • Architect: BLC Architecture
    • Contractor: Starling Richardson
    • Plano ISD Construction Administrator: Warren Kinsey

    Scope

    Provide a refurbishment and overall renewal of the existing school. The building will receive all new finishes throughout including paint, carpet and tile. Also new casework, new metal lockers, new ceiling tile and grid. The existing kitchen also receives a complete remodel with all new equipment. Two classrooms are also being added.

    Timeline

    • Design Initiated: 6/2017
    • Design Completed: 2/2018
    • Construction Started: 3/2018
    • Construction Completed (Summer Refurbishment): 8/2018
    • Kitchen and CR Addition Completed: 2/2019

    Status

    Complete.

    Construction Contract Amount

    $6,829,000

    Actual Construction Cost

    $6,744,824.71

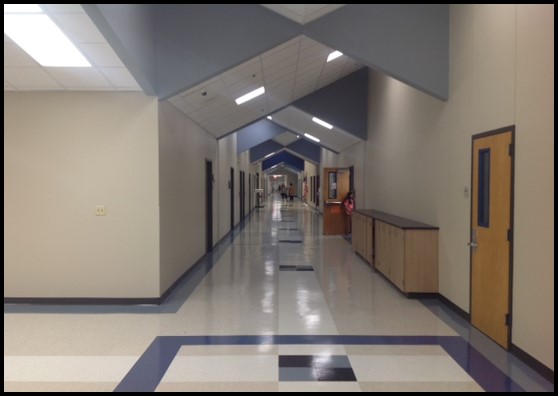

    Main Hall, September 2018

    Main Hall, September 2018

    Classroom addition

    Classroom Addition, March, 2019

    Gulledge Elementary School

    6801 Preston Meadow Drive, Plano, TX 75024

    • Architect: WRA Architects
    • Contractor: Starling Richardson
    • Plano ISD Construction Administrator: Quincy Lara

    Scope

    Provide a refurbishment and overall renewal of the existing school. The building will receive all new finishes throughout including paint, carpet and tile. Also new casework, new metal lockers, new ceiling tile and grid. The existing kitchen also receives a complete remodel with all new equipment.

    Timeline

    • Design Initiated: 5/2016
    • Design Completed: 10/2016
    • Construction Started: 3/2017
    • Construction Completed: 8/2017
    • Kitchen Remodel Completed: 10/2017
    • New Chillers Completed: 8/2018

    Status

    Complete. Project funds allowed for two new chillers to be added to the original scope of work.

    Construction Contract Amount

    $5,607,236

    Actual Construction Cost

    $5,636.290.70

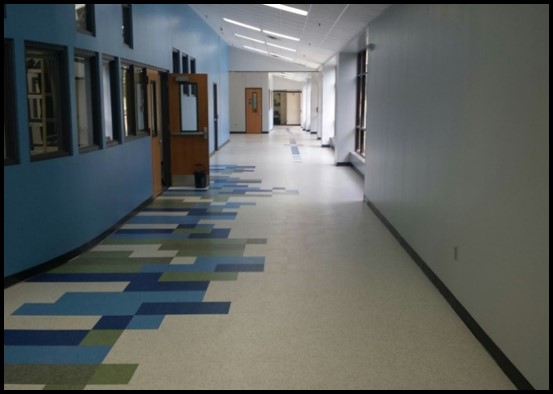

    Refurbished hallway

    Refurbished Hallway, June 2017

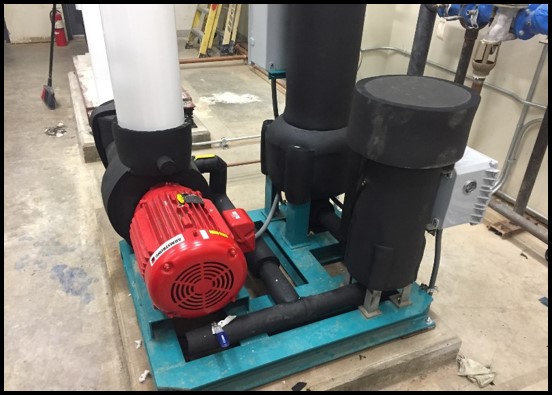

    new soils separator

    New Soils Separator, September 2018

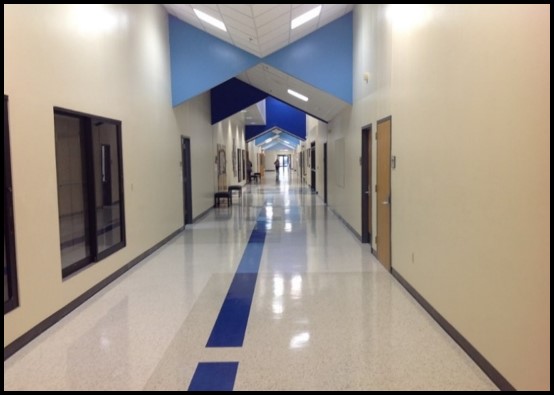

    Haggar Elementary School

    17820 Campbell Road, Dallas, TX 75252

    • Architect: WRA Architects
    • Contractor: Starling Richardson
    • Plano ISD Construction Administrator: Warren Kinsey

    Scope

    Provide a refurbishment and overall renewal of the existing school. The building will receive all new finishes throughout including paint, carpet and tile. Also new casework, new metal lockers, new ceiling tile and grid. The existing kitchen also receives a complete remodel with all new equipment.

    Timeline

    • Design Initiated: 5/2016
    • Design Completed: 10/2016
    • Construction Started: 3/2017
    • Construction Completed: 8/2017

    Status

    Complete.

    Construction Contract Amount

    $5,876,489

    Actual Construction Cost

    $5,528,189.06

    Refurbished Hallway

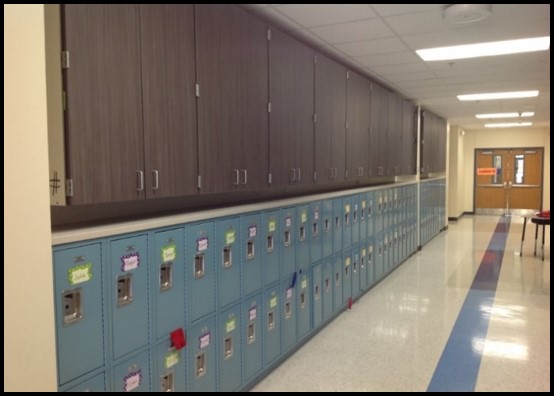

    Refurbished Hallway, October 2017

    Refurbished Classroom Pod, October 2017

    Refurbished Classroom Pod, October 2017

    Haun Elementary School

    4500 Quincy Lane, Plano, TX 75024

    • Architect BLC Architecture
    • Contractor: Bartlett Cocke
    • Plano ISD Construction Administrator: Warren Kinsey

    Scope

    Provide a refurbishment and overall renewal of the existing school. The building will receive all new finishes throughout including paint, carpet and tile. Also new casework, new metal lockers, new ceiling tile and grid. The existing kitchen also receives a complete remodel with all new equipment.

    Timeline

    • Design Initiated: 5/2018
    • Design Completed: 11/2018
    • Construction Started: 3/2019
    • Scheduled Construction Completion: 8/2019

    Status

    Substantially complete. Continuing to correct punch list items.

    Construction Contract Amount

    $7,372,362

    Main street

    Main Street, October 2019

    Library

    Library, October 2019

    Miller Elementary School

    5651 Coventry, Richardson, TX 75082

    • Architect: BLC Architecture
    • Contractor: Starling Richardson
    • Plano ISD Construction Administrator: Warren Kinsey

    Scope

    Provide a refurbishment and overall renewal of the existing school. The building will receive all new finishes throughout including paint, carpet and tile. Also new casework, new metal lockers, new ceiling tile and grid. The existing kitchen also receives a complete remodel with all new equipment.

    Timeline

    • Design Initiated: 6/2017
    • Design Completed: 2/2018
    • Construction Started: 3/2018
    • Construction Completed: 8/2018

    Status

    Complete.

    Construction Contract Amount

    $5,989,000

    Actual Construction Cost

    $5,895,024.95

    Main hall

    Main Hall, March 2019

    Library

    Library, March 2019

    Skaggs Elementary School

    3201 Russell Creek Drive, Plano, TX 75025

    • Architect: BLC Architecture
    • Contractor: Bartlett Cocke
    • Plano ISD Construction Administrator: Warren Kinsey

    Scope

    Provide a refurbishment and overall renewal of the existing school. The building will receive all new finishes throughout including paint, carpet and tile. Also new casework, new metal lockers, new ceiling tile and grid. The existing kitchen also receives a complete remodel with all new equipment.

    Timeline

    • Design Initiated: 5/2018
    • Design Completed: 11/2018
    • Construction Started: 3/2019
    • Scheduled Construction Completion: 8/2019
    • Scheduled Kitchen Completion: 10/2019

    Status

    Substantially complete with the refurbishment. Continuing to correct associated punch list items. The Kitchen renovation is ongoing. The vent hood is installed and currently being ducted in. The wall and floor tile is wrapping up and equipment is set to arrive the first week of October. Freezer/cooler is built. On schedule to complete by the end of October.

    Construction Contract Amount

    $6,632,771

    Main street

    Main Street, October 2019

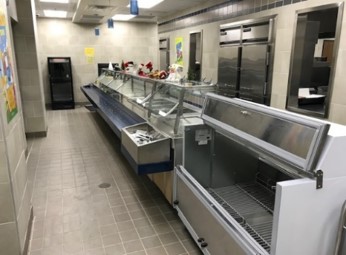

    Kitchen remodel

    Kitchen Renovation, October 2019

  • Upgrades/Refurbishments - Secondary

    Scroll down to view the following secondary school upgrade/refubishment bond projects:

    • Bowman Middle School
    • Jasper High School
    • Williams High School
    • Wilson Middle School

    Bowman Middle School

    2501 Jupiter Road, Plano, TX 75074

    • Architect: WRA Architects
    • Contractor: Cadence McShane
    • Plano ISD Construction Administrator: Quincy Lara

    Scope

    Provide a refurbishment and overall renewal of the existing school. The building will receive all new finishes throughout including paint, carpet and tile. The existing kitchen also receives a complete remodel with all new equipment.

    Timeline

    • Design Initiated: 5/2018
    • Design Completed: 12/2018
    • Construction Started: 3/2019
    • Scheduled Construction Completion (Summer Scope): 8/2019
    • Scheduled Construction Completion (Fall scope): 11/2019

    Status

    Substantially complete with the refurbishment items. Continuing to correct associated punch list items. The Kitchen renovation is ongoing. Currently toothing in the exterior door openings. Interior storefront doors and windows are installed. Electrical and mechanical overhead is ongoing. Double siding the interior stud framing with tile backer board. Roof equipment continuing to be installed. On schedule to complete by the end of November.

    Construction Contract Amount

    $8,720,906

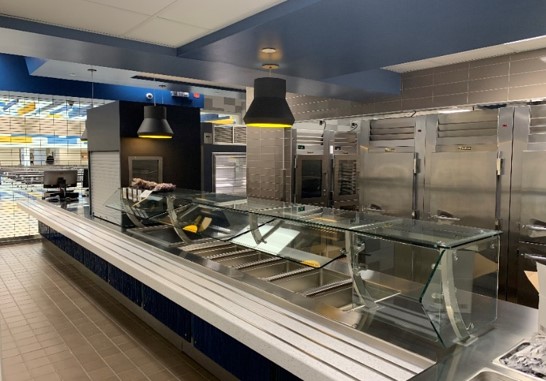

    Kitchen tile backer board

    Kitchen Tile Backer Board, October 2019

    Student commons

    Student Commons, October 2019

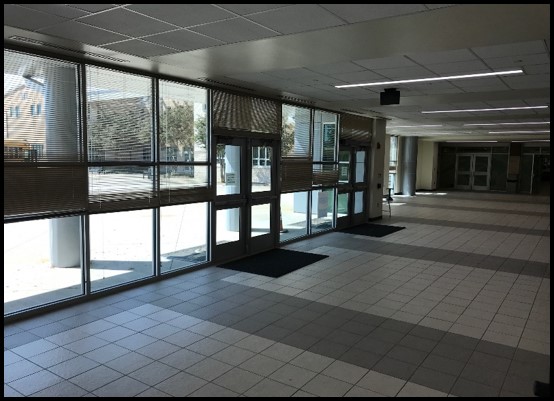

    Jasper High School

    6800 Archgate Drive, Plano, TX 75024

    • Architect: Corgan
    • Contractor: Cadence McShane
    • Plano ISD Construction Administrator: Robert Dean

    Scope

    Provide a refurbishment and overall renewal of the existing school. The building will receive select new finishes throughout including paint and tile. All restrooms will be updated with new tile, partitions and fixtures. Dance will receive a new sprung wood dance floor. New Athletic lockers. The design includes approximately 7,125 square feet of addition which consists of a new art room, new mat room and an enclosed back entry.

    Timeline

    • Design Initiated: 6/2017
    • Design Completion: 2/2018
    • Construction Started: 3/2018
    • Construction Completed (Summer Refurbishment): 8/2018
    • Construction Completed Roof and Art: 12/2018
    • Construction Completed Mat Room: 3/2019

    Status

    Complete.

    Construction Contract Amount

    $10,891,928

    Actual Construction Cost

    $10,891,928

    New art room

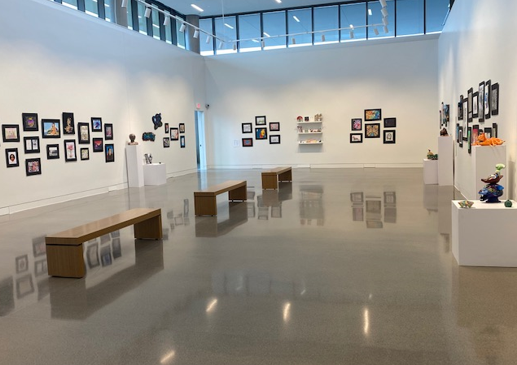

    New Art Room, October 2019

    New enclosed back entry

    New Enclosed Back Entry, October 2019

    Williams High School

    1717 17th Street, Plano, TX 75074

    • Architect: PBK Architects
    • Contractor: TBD
    • Plano ISD Construction Administrator: Quincy Lara

    Scope

    Provide a refurbishment and overall renewal of the existing school.

    Timeline

    • Design Initiated: 5/2018
    • Scheduled Design Completion: TBD
    • Scheduled Construction Start: TBD
    • Scheduled Construction Completion: TBD

    Status

    PBK Architects completed their Long Range Facilities Master Plan and presented it to the Board at the September 17th Work Session. Board members encouraged PBK and district staff to prepare more detailed costs and timelines regarding the possible use of current Bond funds slated for Williams, and for what could be a larger future renovation.

    Estimated Contract Amount

    $5,400,000

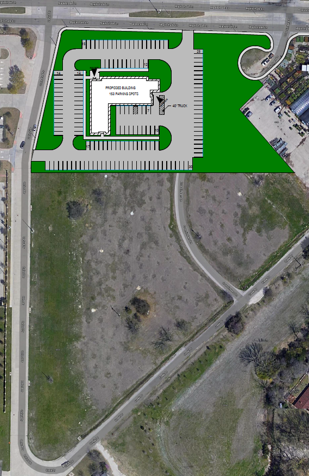

    Williams site plan

    Site Plan, June 2018

    Architect's Rendering new main entry

    Architect's Rendering of new Main Entry, October 2019

    Wilson Middle School

    1001 Custer Road, Plano, TX 75075

    • Architect: WRA Architects
    • Contractor: W.B. Kibler
    • Plano ISD Construction Administrator: Quincy Lara

    Scope

    Provide a refurbishment and overall renewal of the existing school. The building will receive all new finishes throughout including paint, carpet and tile. Also new teacher workstations. The existing kitchen also receives a complete remodel with all new equipment.

    Timeline

    • Design Initiated: 6/2017
    • Design Completed:2/2018
    • Construction Started: 6/2018
    • Construction Completed (Summer Refurbishment): 8/2018
    • Kitchen and Classroom Casework Completed: 1/2019

    Status

    Complete.

    Construction Contract Amount

    $7,136,315

    Actual Construction Cost

    $7,333,130.38

    Additional funds were added for unforeseen conditions, which were not fully realized until the building structure was open.

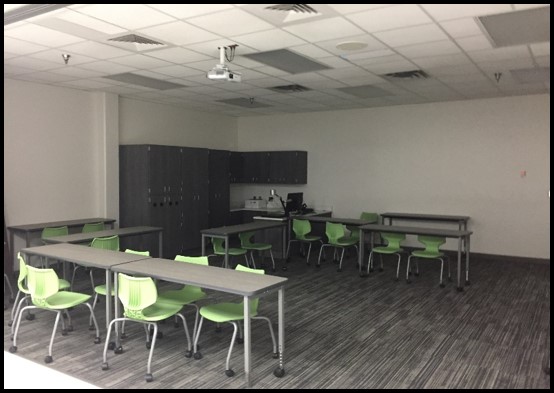

    Classroom

    Classroom, September 2018

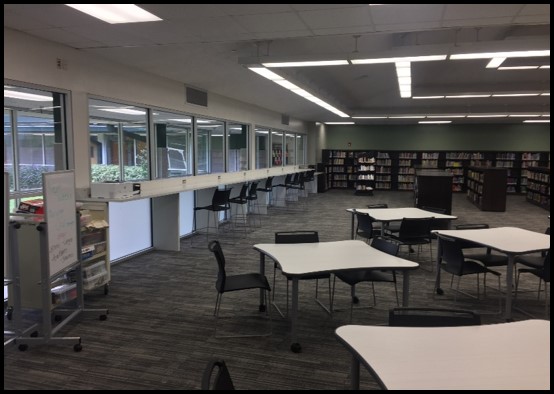

    Library, September 2018

    Library, September 2018

  • Enhancements - Secondary

    Scroll down to view bond secondary school enhancements:

    • Armstrong Middle School
    • Frankford Middle School
    • Plano ISD Academy High School
    • Rice Middle School
    • Renner Middle School
    • Vines High School

    Armstrong Middle School

    3805 Timberline Drive, Plano, TX 75074

    • Architect: PBK Architects
    • Contractor: Cadence McShane
    • Plano ISD Construction Administrator: Quincy Lara

    Scope

    The construction of a new band hall, and renovation of the existing fine arts suite. The completed project will have three distinct practice halls for band, choir and orchestra.

    Timeline

    • Design Initiated: 3/2018
    • Design Completed: 10/2018
    • Construction Started: 2/2019
    • Scheduled Construction Completion: 10/2019

    Status

    Teachers moved back into the building August 5th, and school successfully started August 12th. Band, who gave up their old room to be the new Orchestra room, was temporarily set up in the small gym, and agreed to operate out of this space until the addition is complete and turned over the first week of October. Site paving has been poured. Ceiling grid installation is ongoing. Lights are in. Ductwork is in progress. First coat of paint is on. Door frames and doors are being installed. Wenger practice rooms being built.

    Construction Contract Amount

    $5,049,956

    Band Hall site photo

    Band hall addition site paving, October 2019

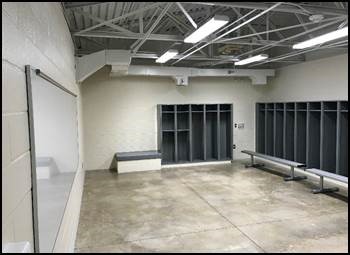

    Interior of band hall

    Interior view of band hall, October 2019

    Frankford Middle School

    7706 Osage Plaza Pkwy., Dallas, TX  75252

    • Architect: Corgan
    • Contractor: Cadence McShane
    • Plano ISD Construction Administrator: Robert Dean

    Scope

    The construction of a new band hall and renovation of the existing fine arts suite. The completed project will have three distinct practice halls for band, choir and orchestra.

    Timeline

    • Design Initiated: 4/2018
    • Design Completed: 10/2018
    • Scheduled Construction Start: 2/2019
    • Scheduled Construction Completion: 8/2019

    Status

    Originally slated for the timeline above, the building permit is still under review with the City of Dallas.

    Construction Contract Amount

    $4,616,581

    Aerial photo

    Aerial of site, July 2019

    Main entry

    Main entry, July 2019

    Plano ISD Academy High School

    1701 Alma Drive, Plano, TX 75075

    • Architect: BLC Architecture
    • Contractor: Wilks Construction
    • Plano ISD Construction Administrator: Robert Dean

    Scope

    Remove the existing brick veneer, examine the existing cavity sheathing system and replace if necessary. Install new air barrier over sheathing, install new through-wall flashings at window and door heads and window sills.

    Timeline

    • Design Initiated: 10/2016
    • Design Completed: 3/2017
    • Construction Started: 5/2017
    • Construction Completed: 11/2017

    Status

    Complete.

    Construction Contract Amount

    $2,508,500

    Actual Construction Cost

    $2,480,298

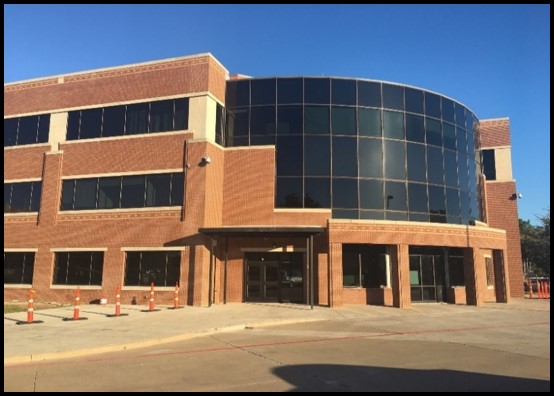

    West elevation

    New Brick at West Elevation, October 2017

    New brick veneer

    New Brick Veneer, September 2018

    Renner Middle School

    5701 W. Parker Road, Plano, TX  75093

    • Architect: Corgan
    • Contractor: Cadence McShane
    • Plano ISD Construction Administrator: Robert Dean

    Scope

    The construction of a new band hall and renovation of the existing fine arts suite. The completed project will have three distinct practice halls for band, choir and orchestra. The campus will also receive upgrades to their kitchen serving line.

    Timeline

    • Design Initiated: 4/2018
    • Design Completed: 10/2018
    • Construction Started: 2/2019
    • Scheduled Construction Completion: 8/2019

    Status

    Substantially complete. Continuing to correct punch list items.

    Construction Contract Amount

    $5,416,302

    Band hall addition

    Band hall addition, October 2019

    Band hall interior

    Band hall interior, October 2019

    Rice Middle School

    8500 Gifford Drive, Plano, TX, 75025

    • Architect: Corgan
    • Contractor: Cadence McShane
    • Plano ISD Construction Administrator: Robert Dean

    Scope

    The construction of a new band hall and renovation of the existing fine arts suite. The completed project will have three distinct practice halls for band, choir and orchestra. The kitchen serving line is also being upgraded, along with all new carpet and VCT throughout the building.

    Timeline

    • Design Initiated: 4/2018
    • Design Completed: 10/2018
    • Construction Started: 3/2019
    • Scheduled Construction Completion: 8/2019

    Status

    Substantially complete. Continuing to correct punch list items.

    Construction Contract Amount

    $6,038,497

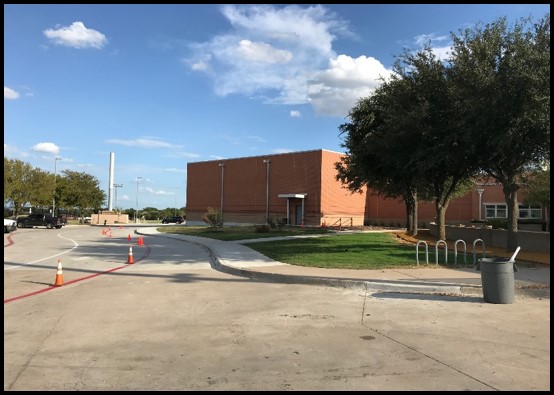

    Rice MS band hall addition

    Band hall addition, October 2019

    Band hall interior

    Band hall interior, October 2019

    Vines High School

    1401 Highedge Drive, Plano, TX 75075

    • Architect: PBK Architects
    • Contractor: Cadence McShane
    • Plano ISD Construction Administrator: Quincy Lara

    Scope

    A renovation of existing space to provide for three larger art rooms. In doing so a computer lab and Project Lead the Way will be displaced across the hall and re-established in the location art abandoned. Also doing an upgrade in the kitchen of select equipment and finishes.

    Timeline

    • Design Initiated: 3/2018
    • Design Completed: 10/2018
    • Construction Started: 6/2019
    • Scheduled Construction Completion: 8/2019

    Status

    Substantially complete. Continue to correct punch list items.

    Construction Contract Amount

    $3,277,183

    Renovated art classroom

    Renovated Art Classroom, October 2019

    Renovated serving line

    Renovated Kitchen Serving Line, October 2019

  • Enhancements - Turfs

    Scroll down to see bond turf enhancements:

    • Phase I Turfs
    • Phase II Turfs
    • Phase III Turfs

    Phase I Turfs

    • Plano ISD Construction Administrator: Quincy Lara
    • Contractor (Three Student Activity Centers): Hellas Construction
    • Contractor (John Clark Stadium): FieldTurf

    Scope

    Replace the existing turf with new artificial turf at four locations. Those locations being the indoor student activity centers at each of the three senior highs, and the field at Clark Stadium.

    Timeline

    Construction Completed: 8/2017.

    Status

    The indoor fields are all complete. Clark Stadium is also complete. GMAX testing on all the new fields has been done.

    Actual Construction Cost

    Three indoor Student Activity Centers: $297,351
    John Clark Stadium: $310,183

    PSHS existing turf demo, May 2017

    Plano Senior High Existing Turf Demo, May 2017

    PESH new turf installed

    Plano East New Turf Installment, June 2017

    Phase II Turfs

    • Engineer: RLK Engineering
    • Contractor: Hellas Construction
    • Plano ISD Construction Administrator: Quincy Lara

    Scope

    Replace the natural grass fields with artificial turf at four locations. Those locations being the track enclosed practice fields at each of the three senior highs, and at Williams Stadium. The project also includes resurfacing the tracks at Plano East, Plano Senior, and Williams Stadium.

    Timeline

    Construction April 2017 – January 2018.

    Status

    Complete.

    Construction Contract Amount

    $4,516,750

    Actual Construction Cost

    $4,801,721.50

    Added a concrete curb around perimeter of running track, and a drainage flume on the NW corner of Williams Stadium. Repair of the existing running track sub-base at Plano Senior High School.

    PWSH new turf, Oct 2017

    Plano West New Turf, October 2017

    PESH new turf Oct 2017

    Plano East New Turf, October 2017

    Phase III Turfs

    • Engineer: RLK Engineering
    • Contractor: Hellas Construction
    • Plano ISD Construction Administrator: Quincy Lara

    Scope

    Replace the natural grass fields with artificial turf at the three Clark Stadium sub-varsity fields.

    Timeline

    Construction April-August 2018

    Status

    Complete.

    Construction Contract Amount

    $2,598,700

    Actual Construction Cost

    $2,579,617

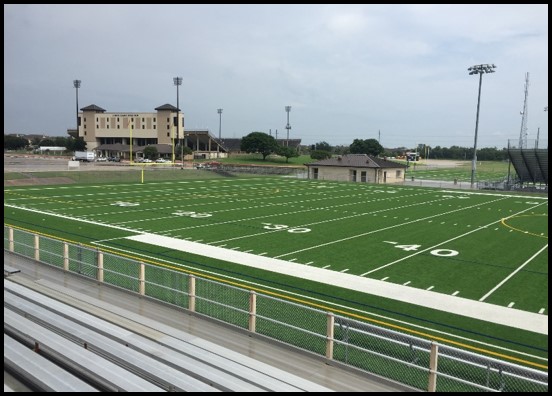

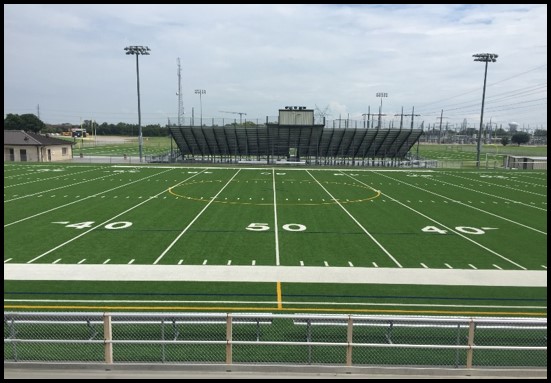

    Sub varsity New Turf, Sept 2018

    Sub-Varsity New Turf, September 2018

    Sub-Varsity new turf, Sept 2018

    Sub-Varsity New Turf, September 2018

  • Portable Replacements

    Scroll down to view bond portable replacements:

    Portable Replacements: $16,020,000. The 2008 bond funds were used in lieu of increasing the 2016 election.

    • Guinn Special Programs Center
    • Plano East Senior High School
    • Wells Elementary School

    Guinn Special Programs Center

    2221 Legacy Drive, Plano, TX 75023

    • Architect: Perkins+Will
    • Contractor: Starling Richardson
    • Plano ISD Construction Administrator: Warren Kinsey

    Scope

    Provide an eight classroom addition to replace the two existing 4-classroom portables on site.

    Timeline

    • Design Initiated: 7/2016
    • Design Completed: 1/2017
    • Construction Started: 2/2017
    • Construction Completed: 8/2017

    Status

    Complete.

    Construction Contract Amount

    $3,375,278

    Actual Construction Cost

    $3,349,846.01

    Classroom additions

    Classroom Addition, August 2017

    Classroom addition hallway

    Classroom Addition Hallway, December 2017

    Plano East Senior High School

    3000 Los Rios Boulevard, Plano, TX 75074

    • Architect: WRA Architects
    • Contractor: Cadence McShane
    • Plano ISD Construction Administrator: Quincy Lara

    Scope

    Provide a 16 classroom addition to replace the four existing 4-classroom portables on site. Through design the plan grew to add 21 classrooms plus a large meeting room for the staff. Project also includes a fully remodeled counselor suite.

    Timeline

    • Design Initiated: 8/2016
    • Design Completed: 4/2017
    • Construction Started: 5/2017
    • Construction Completed: 7/2018

    Status

    Complete.

    Construction Contract Amount

    $8,931,349

    Actual Construction Cost

    $8,485,608

    PESH new addition exterior

    New Addition Exterior, September 2018

    PESH additon interior

    New Addition Interior, June 2018

    Wells Elementary School

    3427 Mission Ridge Road, Plano, TX 75023

    • Architect: BLC Architecture
    • Contractor: Starling Richardson
    • Plano ISD Construction Administrator: Warren Kinsey

    Scope

    Provide a four classroom addition to replace the existing 4-classroom portable on site.

    Timeline

    • Design Initiated: 5/2016
    • Design Completed: 1/2017
    • Construction Started: 2/2017
    • Construction Completed: 8/2017

    Status

    Complete.

    Construction Contract Amount

    $2,102,821

    Actual Construction Cost

    $2,034,149.36

    Addition hallway

    Classroom Addition Hallway, August 2017

    playground

    New Playground, August 2017

Executive Summary

  • The 2016 Plano ISD Facilities and Technology Task Force, bond executive summary was approved by the board approved on May 7, 2016.
